Official Rate Lists — Faisal Hills

Construction Rates & Payment Plans

Transparent, block-wise pricing for house construction in Faisal Hills. Compare gray structure rates with fully finished house prices for Block A, B, C, D and the Executive Block — preview each plan below or download the official PDF.

Step 1 — Choose Construction Type
Step 2 — Select Your Block

Block A — Gray Structure Payment Plan

Faisal Hills, Taxila — Official PDF

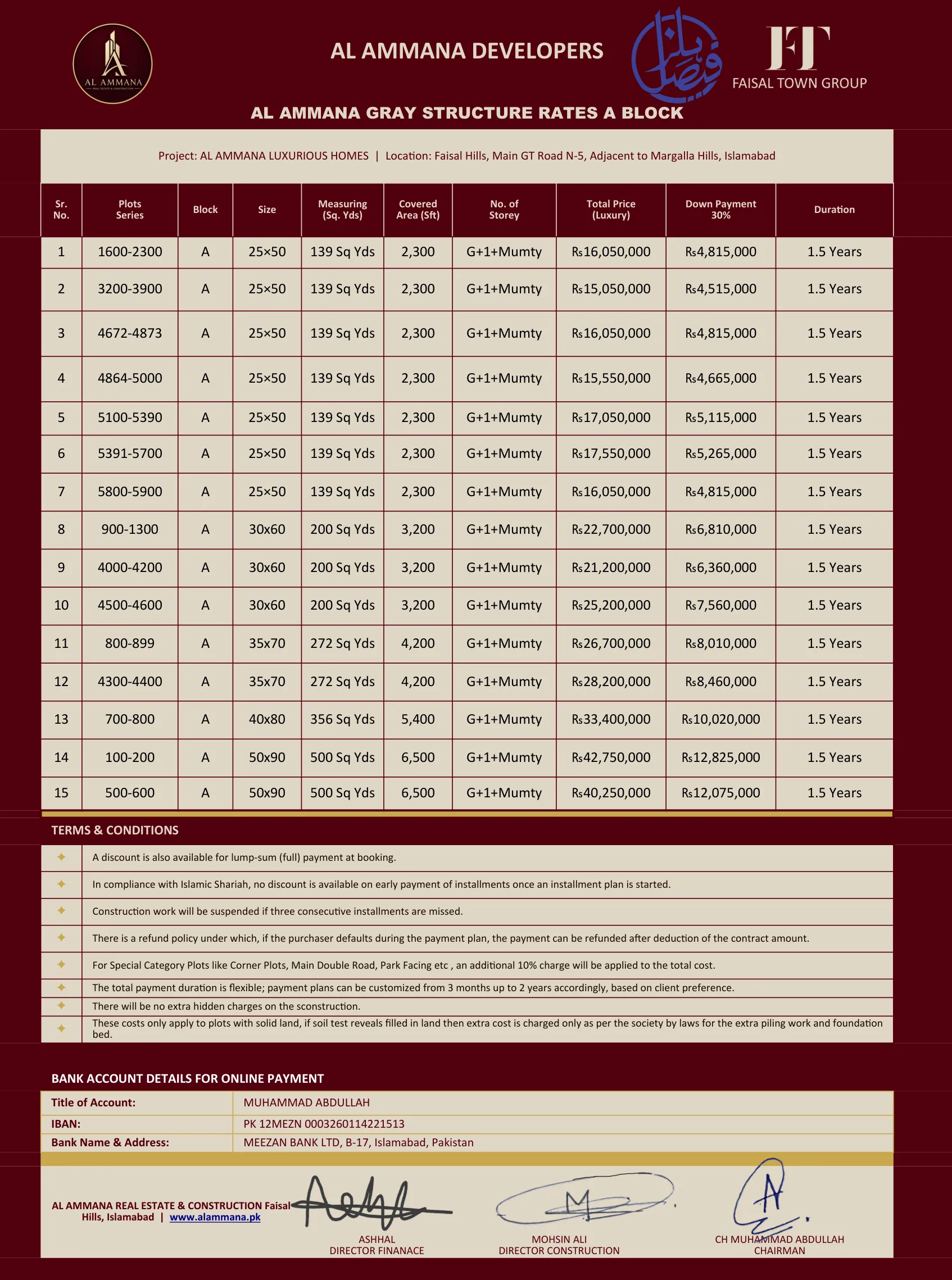

Block A — Gray Structure Payment Plan — rate list for house construction in Faisal Hills

Tap the plan to open the PDF — or use the download button above

Understanding the Rates

Gray Structure vs. Fully Finished

A gray structure shell — walls, slabs and plaster complete, no finishing

Gray Structure

The complete skeleton of your home in Faisal Hills — excavation, foundations, brickwork, roof slabs, internal and external plaster, and underground plumbing. Ideal if you want to manage finishing yourself or in phases.

  • — Foundations & structural frame
  • — Walls, roof slabs & plaster
  • — Rough plumbing & conduits
  • — Boundary wall & main gate structure

You still need: flooring, paint, doors, kitchen, bathrooms, wiring

A fully finished home — complete and ready to move into

Fully Finished

A turnkey home, ready to move in. Everything in the gray structure plus complete finishing to Alammana's premium standard — you receive the keys to a completed house in Faisal Hills.

  • — Tiling, flooring & paint
  • — Kitchen, wardrobes & woodwork
  • — Complete bathrooms & sanitary fittings
  • — Electrical fittings, switches & fixtures

Nothing left to do — you get the keys

How Payment Works

You pay as it gets built

Payments follow construction milestones, not the calendar. You are always paying for work that already exists on your plot — never months ahead of it.

  1. 1

    On signing

    Mobilisation, site set-out and material staging.

  2. 2

    Foundation

    Excavation, footings and plinth complete.

  3. 3

    Each slab

    A payment per floor as the frame goes up.

  4. 4

    Brickwork & plaster

    Walls up, internal and external plaster done.

  5. 5

    On handover

    Final balance after snagging is cleared.

Exact amounts per milestone are set out in the rate list for your block. Gray structure contracts end at plaster; finished contracts continue through finishing in stages.
